NV Energy’s Greenlink West Poised for Progress in 2025
Nev. Regulators Approve Construction Permit for 472-mile Transmission Lin

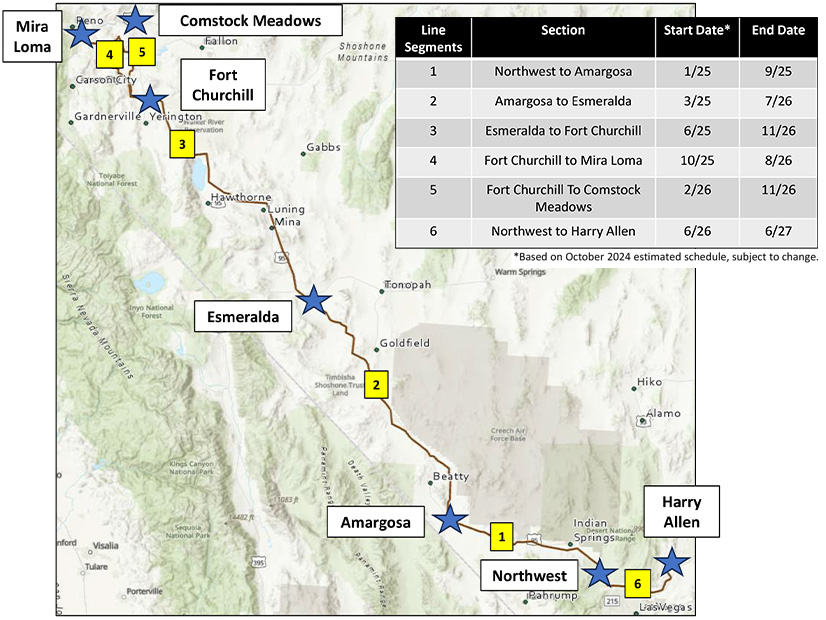

With approvals falling into place for NV Energy’s Greenlink West project, construction of the 472-mile transmission line is expected to ramp up in 2025. | BLM
Jan 2, 2025
|
With approvals falling into place for NV Energy’s Greenlink West project, construction of the 472-mile transmission line is expected to ramp up in 2025.
